Rail
Challenge
Crossrail required increased bearing capacity beneath new rail depot foundations. Conventional mini piling was proposed, but the project demanded a faster, lower-disruption solution that would minimise programme delays and site impact.
Solution
Geobear strengthened the existing ground using engineered geopolymer injection beneath foundation pads and strip foundations, achieving the required bearing capacity within 10 days, verified through independent plate load testing.
Pads strengthened
Strip foundations improved
Programme time
As part of the redevelopment of Ilford Rail Depot for the Crossrail programme, new maintenance facilities required foundation improvements to support additional structural loads. The existing ground consisted of sand and clay deposits that required strengthening before construction could proceed.
Conventional mini piling was initially considered to increase the bearing capacity beneath the proposed foundations. However, the project team sought a solution that would minimise programme duration, reduce disruption and avoid the complexity associated with piling works.
Following an engineering assessment, Geobear's geopolymer ground improvement solution was selected as a faster and more efficient alternative.
The project required ground improvement beneath 19 isolated foundation pads and approximately 168 metres of strip foundations while maintaining a demanding construction programme.
The engineering solution needed to:
A traditional mini piling solution was estimated to require approximately six weeks to complete, creating significant programme implications.

Geobear designed a bespoke geopolymer injection solution to improve the engineering properties of the existing ground beneath the proposed foundations.

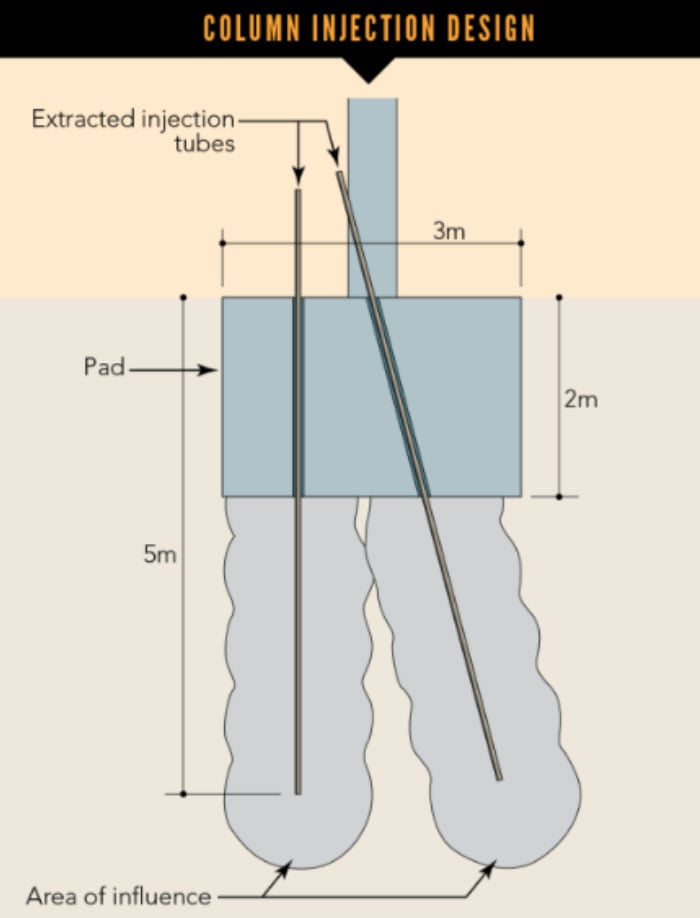

The expanding geopolymer resin was injected through small-diameter holes, compacting weak soils and increasing bearing capacity without excavation or the installation of deep piles.
Treatment was carried out to depths of up to 5 metres, targeting the weak strata beneath both isolated pad foundations and strip foundations.

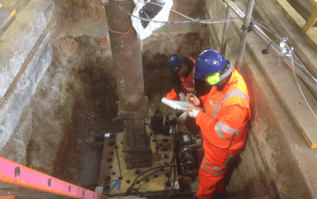

The solution was independently verified using pre- and post-treatment plate load testing to confirm that the required design bearing capacity had been achieved.

The project was completed in just 10 days, compared with an estimated six-week programme for conventional mini piling.
The required 350 kPa bearing capacity was successfully achieved across all treatment areas, allowing construction works to proceed without delay.
By improving the existing ground rather than transferring loads to deeper strata, the project avoided the disruption typically associated with piling operations, including extensive excavation, spoil removal and large construction plant.
The compact equipment also enabled efficient working within the constrained rail depot environment.
